WAZO HILL CEMENT WORKS CONSTRUCTION
1964-1967
“TWIGA” TANZANIA CEMENT CO. Ltd.
DAR-ES-SALAAM
Prelude
We settled in the house
owned by the Bamburi Portland Cement Co. Ltd. Mombasa that was my new employer.
I was appointed as the Chief Structural Engineer and my first job was to look
after the construction progress of the new cement works at Wazo Hill. The
construction site was some 30km north of Dar-es-Salaam, the capital of the
United Republic of Tanzania. My new office room was on the top floor and there
were 3 draught boards placed next to windows two of which were occupied
already. Windows viewed north onto the factory workers camp and the garden
department. The Head office building was a 3-story building incorporated in
factory northern fence line and next to the gate house that had two main
entrance lanes at each side.
I did not have much time to
get acquainted with my new working place and the two draftsmen not to speak
about the plant itself either. A few days after our arrival I had to visit the
construction site at Wazo Hill in its contract’s fourth months. A well known
British contractor MOWLEM E.A. Ltd. got the contract and it was important to
learn more about the project I was supposed to supervise for my new employer’s
company. Everything was absolutely new to me and it would be good to recollect
briefly the political and economical situation of the country where the new
cement works were under construction.

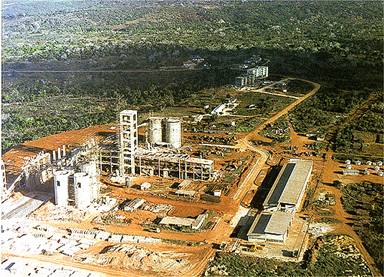

The first aerial views eastward of
the Wazo Hill Works made in August 1964. In front left is the garage, workshops
and stores; at far on top is the main crusher with the sieving plant and
bunker.
Political
situation
Firstly here a brief report
about the geography of the former state of
The
written history starts when Arab traders began colonizing of this region around
700. The Portuguese explorers reached these costal regions at 1500. Portuguese
had some control of the Coast only until the 17th century when Sultan of Oman
took over power over it. In 1885 the German East Africa Colony was established
that encompassed the regions that are now
The
Julius
Kambarage Nyerere (*1922 - †1999) served as the first President of Tanzania, formerly of Tanganyika
from the country's beginning in 1961, and retired in 1985. Nyerere was born in
When
Nyerere became the first Prime Minister he started with his socialist economic
program to be published in the Arusha Declaration on 01.01.1967. He set up the
policy of collectivization in country's agricultural system known as Ujamaa or «Family hood». Nyerere’s
policies can be characterized as socialistic but he was first and foremost an
African, and only secondly a socialist thus he was often called an African socialist. Later he established close
ties with
The co-operation of
Construction
of new Cement Works at Wazo Hill
I had to use EAA (East
African Airways) on my first few flights from
The International airport
was located not far from City centre and company’s driver was waiting for us there
already. There was a Cement Silo Station with an adjacent Packing plant in
Dar-es-Salaam harbor that was owned by Tanzania Portland Cement Co. (TPCC). The
Government owned about 1/3 of its shares in this company. The other but major
shareholders were Bamburi Portland Cement Co. Ltd. (
The coral pinnacles in
the excavation pit for cement silos (Ted Hoskins and Otto Werner) at left and
right the group waiting for a chartered plane departure at
The site of red soil had not
been leveled flat and along its eastern edge it dropped of some 10m to a lower
flat area that reached up to the coastal line some 2km away. In a few larger
excavated pits for structures some kind of white “pinnacles” protruded almost
to the site level. These pinnacles were cones of white hard coral that could be
removed using pneumatic tools later. Yet, cones were far apart from each other
and between were red soil larger patches. Therefore the pinnacles had to be
excavated to a depth of uniform coral rock to get a uniform support for
individual columns foundations.
I found out that the
foundation’s bottom level was arbitrary drawn without any previous soil survey.
The site “zero level” was the most important data for any construction. However
the arbitrary leveled site was above the set zero level meaning that one would
have to carry on with more of site excavation sometime. Only this additional
excavation would allow the correct access to all buildings as well as to
complete the infrastructure works such as roads, drainage, sewage etc. This
would be my first instruction to the contractor as he would be entitled
adequate payments for any extra jobs. Some hard learning stood before me for
the coming months!
The construction works on a
few buildings were well advance or almost in their final stage. The main
crusher (for coral rock) with a sieving plant over a bunker was in use already
as the contractor started producing concrete blocks he needed for on works. The
buildings for stores, workshops and the garage yard were almost ready as to be
handed over to the owner’s utilization. As a sudden blow came when the
contractor’s site agent told us that the design for infrastructure does not
exist yet. Also they did not receive construction drawings for a number of
plant buildings so far. Some complains
followed regarding the detailing of reinforcing drawings that I did not
understand at first. Moreover viewing the contract schedule perfunctorily I
thought the contractor must be about 4 month behind the set out time and in
that case the penalty clause might have to be applied. The departure time saved
us more embarrassments so I returned to the airport bewildered about what I had
seen on my first visit to Wazo Hill site.
The excavations
advanced for the Raw Meal Silos at left and for the Gypsum Crusher at right.
The excavations continue throughout
of September 1964.
Back to the office next day
I had to report about my first visit to Wazo Hill to the General Manager (GM)
Mr. Ian Roberts or Dick. At first he was stunned by my distressing report not
knowing anything about many problems I have learned about. Up to now a locally
employed architect has been visiting the construction site and he had to design
housing for the new company’s staff as adjacent to the plant. Dick asked me to
inform him about my findings so that he could write the site’s report what he
was done in the past since. This I had to frankly refuse and asked instead for
a secretary to whom I would dictate my report. Dick had to accept my proposal
as it became evident to him that a number of serious measures had to be
introduced instantly. Dr. Felix Mandl, the Managing Director (MD), was to
arrive in a few weeks so Dick did not want to confront him with an embarrassing
situation at Wazo Hill. Thus Dick’s decision started an avalanche of changes
that would cause a considerable delay in our anticipated return to
The weeks passed fast and by
end of 1964 I got my own room in the Head office (HO) and also a secretary Mrs.
Pereira. She came from
Now I should continue my
description referring to the development and events linked to the construction
works ongoing at Wazo Hill only. The first thing was to prepare a general site
plan for the Works that should include all buildings and the infrastructure
like roads, surface water drainage, sewage and other utilities. One day
Smolniker who was drafting Plant general plant layout told me about the
dramatic facts regarding the completion of working drawings. Such drawings did
not exist for about one third of plant buildings like the secondary crusher
(for gypsum, silicate clay and iron ore), clinker transport, packing plant with
cement silos, switch house and water tower. When MD learned about the overall
state of design and he asked me to take care about all these deficiencies
instantly. In my desperation I called on my mentor and good friend Otto Werner
asking for his help urgently. Otto responded positively and offered the help by
the many colleagues on the Faculty of Civil Engineering in
At left the deep pit
of the Gypsum crusher and the completed foundations for Raw Meal Silos with the
excavated deep pit for the elevator tower by end of October 1964
This was the beginning of
cooperation with “Werner’s Group” that had completed the designs for the
packing plant and the two silos for cement at first. I decided to deal in our
office with the alimentation bunkers for the raw mill and the cement. These
bunkers were situated within the crane hall where the construction work had
started already. It was best to do the design on spot in close the cooperation
with a malcontent contractor by now. One day Smolniker shocked me again in
finding out the crusher for gypsum and clay is missing too. The crane hall was
situated along the eastern plot’s edge next to a sharp drop of some 10m to a
plane below. There was no free space on the crane hall inner side so we had to
place the crusher and its hopper at the outer side. Thus an access road had to
be constructed along the hall eastern side as it was still enough space across
to the plot edge. Although the solution was simple but the crusher needed a
deep pit bellow the discharge hopper at road level. The final depth depended
upon the elevator footing that had to lift the crushed gypsum or clayey soil
over the crane hall retaining wall some 8m above road level. Thus the crusher
structure had a very deep pit – almost down to the plane level.
I have visited Wazo Hill
almost every week where the Contractor’s Clerk of Works Mr. Ted Hoskins became
my best counselor and helped me a lot in getting the project well up to its
faster way. Ted introduced me to Norman & Dawbarn Co. who was a Quantity
Surveyor (QS) on this project. This kind of services was new to me and it took
me some while to adjust to the different contract procedures and policy that
differed from the socialistic ones significantly in many aspects. I had to learn
fast from mistakes on my first project of private ownership and with Ted’s help
and guidance I got hold on this somehow deficiently started Wazo Hill project.
The experienced I gained here was the basis for my future project for the
cement industries all over the World.
View down on the
concrete block making yard close to the sieving plant at left. Seen at right is
the inner raw of Crane Hall foundations near to Raw Meal Silos and Kiln
foundations seen at top of.
The delayed receipt of detailed
reinforcing drawings by the contractor was caused by an almost idiotic
conversion of the metric dimensions to the imperial ones. Many of these
drawings were drafted in
By end of 1964 I got the
project at Wazo somehow on the rail but both MD and GM were of the opinion that
I have some spare time. Thus I got involved in some jobs at Bamburi like supervising
the
However there were some
positive developments that helped to speed up the loose ends say at Wazo Hill.
The general survey map of the plot has been completed so I could start with the
infrastructure planning at last. First we laid the internal factory roads that
enabled access to various buildings and in particular to the stores, workshops
and the garage works badly needed already. The overall surface drainage caused
a major problem because the crane hall cut off the natural draining direction
over the plot edge. Then I had decided to place the main outflow pipe deep
enough to be save across the hall’s floor. I did not like this solution but had
not other choice. The pipe was situated next to the deep excavations of
alimentation bunkers below the dividing wall inside the Crane hall bypassing
the deep pit for the gypsum crusher outside of. The outlet pipe deep position
provided a good slope for the Works internal surface drainage.
The design and construction
problems did not stop yet. The large and heavy foundation rotary kiln
foundations did not require a too deep excavation though. The pinnacle’s bases
were much deeper than that of required excavation depth so I worked out a new
method to create a proper basis for Kiln foundations. One had to cut off
pinnacle’s head at prescribed depth, excavated and/or cleaned out the soil in
between to be replaced by lean concrete then. The drawback was that such work
was not specified in the contract so the QS in charge calculated new and
appropriate unit rates that I accepted as the Engineer in Charge. All these
procedures were new to me but I was learning more and more as I worked on my
first project of this kind and of considerable volume that is value.
From left columns and
retaining walls of Crane Hall outer raw, block work as inner shutter for Raw
Meal Silo with wall reinforcement and completed deepest pit in coral rock for
Gypsum Crusher elevator.
Now the contractor had
brought in heavy earth moving machines so one could start with the site
leveling and the preparation of road beds. The company contracted a Cessna
aircraft with a pilot so the contractor leveled a landing strip next to the
site at Wazo. This resulted in a reduction of travel costs as well as of the
wasted time making more efficient travels from
The top inspectors
(Dr. Mandl at right) of the opened Quarry Trench with shovel dredger at rear of
left picture and advanced construction of Crane Hall columns inner raw with
bunkers at far left. In background are the well advanced Kiln foundations by
February 1965.
On the site there were two
concrete batching plants and the cement was delivered in bags from the packing
plant in harbor. The crushed aggregate came from the newly opened quarry of
Wazo plant. At first large quantities of concrete were produced to cast the
foundations. One used motor-driven tippers efficiently to distribute the
concrete in batches of say 0.5m³ at ground level. However smaller man-pushed
tippers could fit on the elevator lifting platform only. The later type of
tipper was known as “japanner” as it had a bucket for about 0.1m³ of concrete
mounted between two large wheels. A wide concrete surfaced yard was used to
stack concrete blocks but also to prefabricate some elements of reinforced
concrete needed for say the Crane hall.
Construction progress
on site by February 1965: build-up with concrete blocks of internal walls in
Raw meal storage silos
at left and Crane hall west side columns and bunkers and Kiln foundations in
background at right
The cement works had a
central storage facility provided by the process design of that time. The Crane
hall was obviously the solution in that raw materials were stocked up at one
side where as cement clinker and gypsum were stored separately. The Crane hall
design followed a well probed structure type that had the main columns at 8m
c/c with retaining walls 8m high in between. The later ones were vaulted and
slightly inclined made of concrete block thus forming a barrel shell. The crane
beam top was at 12m above the floor on that a crane or more run along the hall
on rails 20m apart. The fixing of crane rails had caused many problems before
but at this plant the fixation detailing had been used successfully on several
other plants already. The crane grab discharged stored raw materials (raw
materials like coral and clay, and clinker and gypsum) into the alimentation
bunkers of the two mills.
Left the first ever
constructed barrel shell roof for the Clinker storage hall in the Cement Works
in Beočin (
The crane beam had at thick
slab to outer side that took lateral loads caused by crane side ways movements.
At the same time this slab was the lower cord longitudinal truss between the
columns and its top cord was the edge beam cum gutter for the barrel shell
roof. The Crane Hall roof was structurally a barrel shell spanning 24m with
ribs at 4m c/c on top of. The barrel shell has been cast in situ on top of a shuttered
platform supported on trussed scaffolding that one moved along on crane rails.
There was an expansion joint 8m apart in the shell thus at the center of Crane
hall columns. The top ribs had been concreted after the hangers were placed
through each holding a pair of tie rods of Ø30mm. The tied rods (with
turnbuckles) took the full tensile strain of the shell lateral thrust when the
shutter platform had been pulled to the next bay of 8m. This barrel shell roof
was the classical structure invented by Mr. Hubert Spannring long before the
design theory had been worked out in 1950s. The first barrel shell roof of 15m
span had been constructed on a storage hall for the Cement Works at Beocin in
the former
The large building attached
to the Crane hall accommodated the Raw Mill at one side and the Cement Mill on
the other one. This was not a common solution as these two types of mills
normally do have separate buildings often far apart from each other now a days.
In this particular case the wide building had a roof of trussed arches spanning
of 24m placed 4m c/c cast in situ. For the roof cover one used prefab slabs of
50cm width the same as for the Crane Hall. Subsequently the joins between slabs
were cast in situ as well as the wider joint on the arch itself making the
whole system a barrel shell at the end. The lower cord of arched truss was the
tie of the barrel shell. This type of a barrel shell roof system yet as a
prefabricated method has been developed by Otto Werner in the early 1950s. It
was used on many industrial buildings with long spanning roof that could be
supported at the edge of a building only.
By end of 1964 several
buildings got out from their foundation pits. Columns stood out like spikes all
over the site that had leveled in general in accordance the plant layout
prepared in the design office at Bamburi. The contractor started erecting
several elevators that would enable lifting of materials to the upper floors of
buildings. I was glad to see that the contractor used ACCROWS
Aerial view on the Crane hall columns
up to crane beam level and bunkers almost ready by May 1965 left and at right
completed HET and kiln house, bunkers in Crane hall and cement silos by
September 1965.
The foundations for two Raw
Meal Silos were completed and the contractor was ready to start with the
shuttering for circular wall on one of. Masons started using concrete blocks to
form the internal shutter for that wall. I was told that this method was
specified by the contract (?) so I started an enquiry whose brilliant idea was
to do it. Back to Bamburi I had got the answer from Smolniker who told me about
that the first silos here were build that way in 1952 here. I had stopped that
practice instantly as rough blocks’ surface impedes the flow of substance in
the silo. This was particularly the case with the fine grinded raw meal to be
homogenized by strong air flows.
The Raw Meal Silo consisted
of two compartments: a lower for storage and an upper for blending. In the
blending silo the fresh milled meal was homogenized and when processed it was
flowing down in the lower section to be used as for the kiln feed. Then after
the contractor used ACCRORWS circular double steel shuttering of 4ft height
that slid up the wall at say two days intervals. The building of an internal
wall with concrete blocks was a tedious and time consuming process so the
contractor happily accepted my instruction to stop it. The two raw meal storage
silos were the last built in this old fashioned method. Luckily I never got any
rebuke from Dr. Mandl who obviously agreed to that former method when he
started building the Bamburi plant in 1952.
The crane rail bedding ready for
casting in and movable roof shuttering moved to the north end of Crane hall at
left. At right completed the Crane hall raw materials storage areas with
bunkers seen from a crane.
By mid of 1965 Martin
Froehlich, a mechanical engineer who escaped from the East Germany, was
appointed as the Technical Director and moved into his house first. Mr. O’Shea
came as the second to become as Company’s Chief of Account. Now ready flats
were steadily occupied by future plant supervisors and a few erectors from
various plant suppliers. Some of plant buildings were ready for the machinery
erection and Martin got some headaches to coordinate and organize the erection
works with the building contractor finishing a few of his “building tails”.
Martin Froehlich and Ted Hoskins
inspect progress of works on Blocks of flats left and the Senior staff house
allocated to Martin as the General Manager of TPCCo.
The construction progress
was good on the two senior staff houses and two blocks of flats. Thus I
informed Dr. Mandl on his visit to Wazo Hill by end of 1965 that the plant’s
new staff would be able to move in a few weeks time of. I could submit him the
finished design for factory’s infrastructure that included a cost estimate
prepared by our QS. The estimate was based upon contractor’s unit rates and the
costs were about T£30.000. It came like a shock to MD as it was an additional
expense of 10% on the contract sum. We had a long discussion with a few
reprimands to me (not be neither the first nor the last ones!) I got the
permission to spend T£15.000 only. Therefore I decided to build so much of
infrastructure as possible with that amount that resulted mainly in a reduced
finish road surfaces. The road was constructed from the gate house leading to
stores, workshops and garage workplace. Another short branch was completed as
the access to Packing plant and the front of new Head office being under
construction now.
By end of 1965 the
Governments of China and
The Ubungo Railway
loading station from left: the roof scaffolding, placing and fixing of
reinforcement on the folded roof slabs first ever constructed in
One of the requirements was
a minimum of columns in the two compartments that width was 16m and 14m
respectively. There were two railway tracks for a total of 6 wagons and all of
had to be plied by the loading arm from above. The movable loading arm was
heavy machinery hanging on two rails on that it moved along the wagons. I
decided to design the roof as folded plates that structural system was my
specialty and certainly nobody build something alike in
At left view on the movable shutter
for the Crane hall shell roof including the longitudinal truss girder on top of
the crane beam. At right view from left: Heat exchange tower, Mills building
and Crane hall
Despite all setbacks it
looked like that the plant might go on trial production some time in last
quarter of 1966 already. Then in May Dr. Mandl visited the site again and
became so furious seeing that a part of road surfacing was completed only. At
first I swallowed a hard clump not to answer “that is what one gets for
T£15.000” but as the conclusion I got a free hand to complete the
infrastructure as estimated for. I could reduce my visits to Wazo Hill that
suited me well because I was heavily involved with the large construction works
going on at the Bamburi plant where a major extension was well underway
already.
The plant at Wazo Hill was
the first Rotary kiln with a Heat exchange tower (HET) to produce the clinker
in a dry-process. The general manufacturer was KHD Cologne,
The aerial view
southwards shows the construction progress by end of 1965. At right is the
building accommodating the garage, workshops and stores. Road construction just
started.
The lifting of heavy
machinery parts was the real problem provided there was no heavy mobile crane
available. Thus one designed two cantilevers on top of the HET to that one
fixed heavy joists with a system of pulleys. A wide opening was left in the
roof of Kiln house through that one lifted the cyclones on HET appropriate
floors. The kiln sections were lifted the same way to be moved into right
position on a sledge gliding on rails fixed on top of kiln foundations. The
constructed kiln house roof was the last of its kind as it was useless in a
tropical country. On some other buildings cantilevered steel joists with
pulleys had been fixed temporary to winch up various parts to appropriate
floors. To incorporate an obligatory lifting system on all buildings accorded
with manufactures was the essential experience for me in future.
The assembling
progress is well on of the Rotary kiln and the cyclones in Heat exchange tower
in December 1965. The roof of Kiln house is still open but various trial runs
are due to start soon.
The mechanical and
electrical engineers started assembling the machinery and other equipment subsequently
to builder’s completion of any of the plant buildings. Any plant section had to
go through a number of running tests first. By autumn of 1966 the whole plant
was ready to start the full operational runs. However there were continuing
break downs here and there in various sections that became a real nuisance. Of
course the employed local labor was not used working in an industrial complex
of this size and complexity yet. The General Manager Martin Froehlich had
installed three light bulbs on top of the Heat exchanger tower. Thus he could
see the lights from his house even at night – green meant plant runs smoothly,
yellow there is minor stoppage somewhere in a part of and red meant that the
main process system came to an abrupt stop. All the troubles seemed to be more
of a persona’s kind of matters than being caused by the plant equipment as
such. Martin went to the Minister for Industry to seek an advice and got a
straight forward answer to bring in the witchdoctors to exterminate the bad
spirits out of the plant.
The Railway loading
station at Ubungo completed by mid of 1966. The loading into wagons started
soon after the plant went into trial production. At right seen is the movable
loading boom
The Managing Director at
Mombasa Cement Works Dr. Felix Mandl could not believe to such an advice and
asked his good friend the President of Kenya Jomo Kenyatta for his views to.
After
A number of local witchdoctors
came to view and tour around the cursed plant some days after. At the end of
they tour they agreed their magic powers are too weak for such a great job. At
last they decided to call in the greatest magicians living in the region of
Morogoro who then willingly accepted this task as the bush drums informed
later. A few days later a number of fairly mystifying looking men arrived
followed by an entourage of helpers. Their Chief in charge accompanied by few
Unionists met Martin to whom they submitted a list of items that would be
needed for the ceremony. At the end of a rather long list also were two living
oxen to be required for their rite too. The company had to provide a specific
quantity of linen in different colors, a lot of crushed maize corn known as
“posho”, several pints of “pombe” that is the fermented coconut milk – all
should be used in the exterminating process of bad spirits.
The assembling
progress is well on of the Rotary kiln and the cyclones in Heat exchange tower
in December 1965. The roof of Kiln house is still open but various trial runs
are due to start soon.
The magicians went around
the site searching out every of Baobab trees in circumference of the plant
nearer area. They placed the appropriate donations for demons under each of the
Baobab tree according to the ritual. As the quantity of endowments did not
suffice at first more linen, posho and pombe had to be purchased hastily. The
Chief magician made a small hut of colored linen looking like a shelter in that
he placed a handful of posho and a cup with pombe on top of a spread white
linen sheet. Shortly before sunset two oxen were brought in close to the Heat
exchanger. First the helpers broke the oxen’s knees so that it could not run
away. Then the neck artery was cut open and the gushing blood collected in
larger bowls. This gruesome process lasted quite some time until both oxen bled
entirely out. Afterwards the animals were slaughtered and butchered cutting the
meat into smaller pieces to make the stew for all who attended the rite.
Everybody working in the factory was invited to attend that whole ritual rite
except for females who were not allowed to be present at all.
Seen at left is the top storey of
Mills’ building with the assembled Electro filter and the Heat exchange tower
left of. Raw meal blending & storage silos (two storage silos only at back)
are shown at right.
The witchdoctors took the
bowls with animal blood and smeared a patch on each of the plant buildings. The
patch size apparently depended upon the importance of a particular building as
considerate by the Chief witchdoctor. We
could not envisage why the largest patch was on the Heat exchanger building –
certainly it was the most important and largest one in the factory. After sunset
most of the Europeans left this congregation that continued to enjoy the stew
and even more of pombe long in the night. A few days after this eventful ritual
was done something unbelievable happened. All the plant machinery was running
almost smoothly. The green light on top of the Heat exchanger tower shone green
for days without turning to yellow or even red. It seemed like that the “bad
spirits” have been appeased and that the plant future was the most promising
one.
The construction works
are completed of the two Cement silos at left and the Mills’ Building (for
cement and raw meal) and the Heat exchange tower shown at the right picture
In the past months the
contractor MOWLEM pulled out from the site completing all the works under the
contract including the new Head office building. The QS had submitted the Final
Bill of Quantities (BofQ) that included the total amount due to the Contractor
and the list of payments received up to date. There were two subtraction
amounts to be considered first of was the Withholding money payable to
Contractor after warranty time expires. The second amount would be a rather
disputable one as it dealt with the contractor’s negligence to complete the
works in time agreed upon in the contact.
In the Rotary kiln and
the Heat exchange tower started the trial runs in July 1966 as seen at left
picture. Clinker transport, Water
treatment plant with tower and Switchboard house are shown at right.
Thus it was necessary to
call for a meeting in presence with Dr. Mandl so I invited Mr. Bridle, the
Director of MOWLEM (EA) Ltd. to be our guest at Bamburi. The guest’s room had
to be made ready so my wife checked the bed thoroughly before putting bed
sheets on etc. To her dismay she found dozens of geckoes’ eggs placed
underneath in the opening of the mattress’s cover. Our daughter collected all
these eggs because geckoes were a real nuisance because their vast number.
Geckoes were hiding almost everywhere and left their black droppings
ubiquitously at any place even on ready food plate etc.
We had a pleasant evening
and Mr. Bridle commented Ljiljana’s dinner after that talked long into night
sitting on the verandah enjoying the moonlit sea view. We warned Bridle
jokingly about possible geckoes visiting their egg laying places in that he
would sleep. The next day at Bamburi’s HO was not to be as pleasant when talks
stared on the final BofQ and the payments due to the Contractor. We could agree
on all items except for the T£8.000 estimated as the negligence because of
delayed completion. At this critical moment Dr. Mandl appeared like “Deus ex
machina” in the room and invited Mr. Bridle for a word in his office. Some
minutes later both returned announcing that the argument has been settled by
reducing the disputed amount to T£4.000. Everybody was happy about the outcome
and we ended the contract with a lunch in a
The official opening of
Tanzania Portland Cement Co. Ltd. was fixed for
An employee in Bamburi
Works’ Building department Italian Fabrizzi was the right specialist for this
kind of a job. He made a number of pieces out of the giraffe sketch each about
60cm long. The pieces were cast with brown stone that was then polished in
terrazzo art technique to comply exactly with the sketch drawn by Tibor. Each
of the pieces had cast in pins on the back side that would enable the fixing on
a wall later. Fabrizzi also made a number of slabs in black-white terrazzo
technique as to emphasize a natural background.
At left Tibor and
Zvonko go up the staircase, Martin and Tibor with the TWIGA sculpture at entrance
hall of the Head office. Seen at right is the Water treatment plant and its
Water tower.
When everything was ready
the sculpture TWIGA was assembled on a grassy plane in front of the window of
Dr. Felix Mandl room on first office floor. I went to call Dr. Mandl to look
out of his window to see the “giraffe” laid out on the grass. On my way in Dr.
Mandl’s secretary warned me that he has a VIP visitor in his room. She
announced my coming first and then went to the window herself to view the
sculpture.
Dr. Mandl stood up somehow
reluctantly but seeing the giraffe laid out on grass got so furious and started
scolding me angrily how could I dare to spend so much money on this “object”.
At first I stood there stunned and shocked! Luckily for me the VIP guest, who
was Dr. Mandl’s best cousin, as well as the secretary were both so enchanted
with the TWIGA. They saved my skin for sure! After a while Dr. Mandl agreed
that we could fix temporary that “object” until his final scrutiny when he
makes the inspection of the Head office at Wazo Hill next time. I left his
office happy about the outcome thanking heartedly my saviors. I explained also
that the costs of making the “thing” were almost none and that TWIGA sculpture
we have considered it to be a present to the new Works.
Then every part of the
“object” was carefully packed and shipped to Wazo at next occasion. Few days
after Fabrizzi went to Wazo to supervise the fixing of all parts on the wall at
the Head Office entrance hall. Additionally Tibor Gaal asked a line to be
incised in the wall above the sculpture itself and to paint it in black. The
incision would symbolize the silhouette of Kilimanjaro against the bluish-grey
wall paint.
The Head office building is ready for the opening ceremony – at left the northern front and at right the western front with carports. Note the folded plates design used for the cantilevered entrance to the Office building and as the roof over carports.
There was one more technical
problem to be solved about the sewage system prior to the official opening. All
users within the plant and in all residences were linked by already placed-in
pipes up to the outlet that ended at the plain below the factory. Close to the
later one ended the plant surface drainage outlet too. I choose for to treat
the sewage effluent with the aeration system that consisted of two shallow
ponds. To activate the fermentation process in the first of two ponds it was
necessary to throw in a dead cat (it is true so no laughing, please) when the
sludge got to an appropriate level. One had to wait to until the level got to
say 60cm high so that the fermentation process could start when one threw a
“dead cat” in that took several days of waiting though. The second pond got
filled up by the overflow from the first one what did not matter as it was
meant for the final aeration cum evaporation only. For that did not have wait
at all. It was essential to maintain the sludge level at say 60cm in the first
pond what was not so easy because of the low quantity of effluent from the
housing estates. It helped to add some outflow from the water out of the plant
cooling system and from the surface drainage for a while at least.
On
The Head office
building is ready for the opening ceremony – at left the northern front and at
right the western front with carports. Note the folded plates design used for
the cantilevered entrance to the Office building and as the roof over carports.
In his opening speech
Mwalimu (The Teacher) said that the new and big cement factory will produce
cement for the State of Tanzania from now on. According to the Arusha
Declaration the factory belongs to the Peoples of Tanzania now. Following this
rather chilly opening speech Dr. Mandl had reiterated in fairly strong words
saying that he had experienced such nationalization some time ago meaning that
in Yugoslavia. Then he suggested that the President would certainly be wise
enough to keep the experienced expatriate technical staff until Tanzanians
learn how to operate this complex industry for the good of their country.
Of course the opening
ceremony continued in a somewhat depressed mood with guests sightseeing the
plant in guided small groups. All systems worked to their best and the green
light was on! On the other hand I had won my “prize” when the guests gathered
in the Head Office foyer and commended the exceptionally captivating TWIGA
sculpture to Dr. Felix Mandl. I never heard any word about the TWIGA from him
later at all.
The Main entrance to
the Wazo Hill cement works of TPCCo Dar-es-Salaam at left and the Gate house on
the day of the official opening February 8, 1967.
Light meals and drinks were
served in a few offices but there was no excitement like during the extortion
of bad spirits several weeks ago. Most of the guests dispersed soon after
Mwalimu left including his followers and we had to hurry to the airport to
catch the flight to
Epilogue
By end of February 1967 we
left our house in Bamburi for good. We were due to travel via Rom to
Blocks of flats are
occupied as well as junior Staff houses on the plane below the Works in 1966.
The Tanzanian Government
paid out the foreign shareholders. Subsequently it entered a new agreement with
Cementia Holding AG for Technical Management only. Martin Froehlich remained at
Wazo Hill until the second kiln line had been assembled. CIPAG produced all the
building drawings for that first extension of TPCC and the 2nd rotary kiln went
into production by end of 1971.
The TWIGA cement works
under full steam as from early 1967. At left view from the entrance on the main
building: Heat exchange tower, Mills’ building and Crane hall in background and
at right the southern end portal with the clinker storage area.
© Copyright 2008 by
Zvonko Springer. All rights reserved.
